Parking Garage Progress
As St. Tammany Health System's parking garage project along South Tyler Street takes shape, we will post regular construction updates to this page. Check back regularly for progress reports as they are available.
April 24, 2026
April 20, 2026

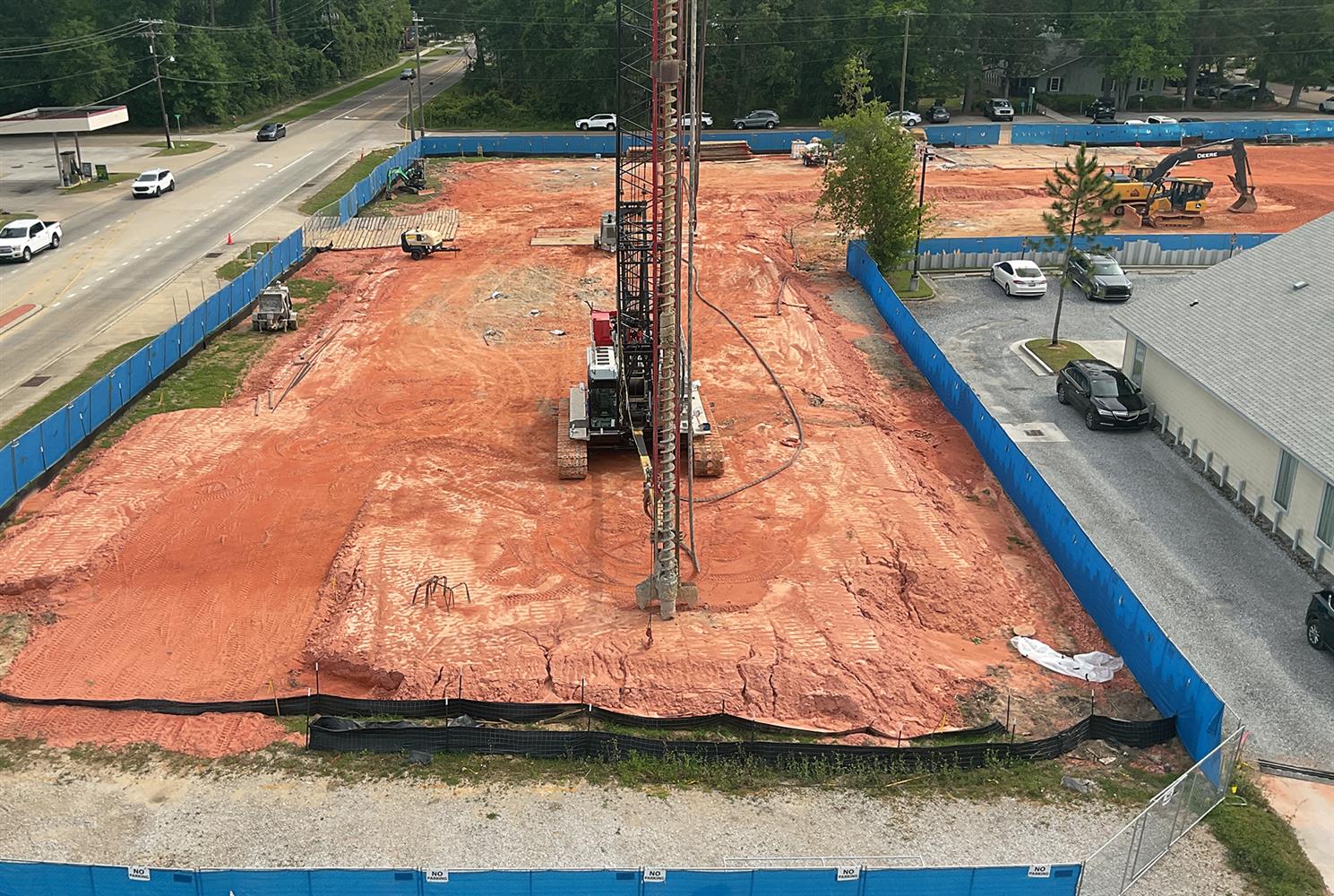

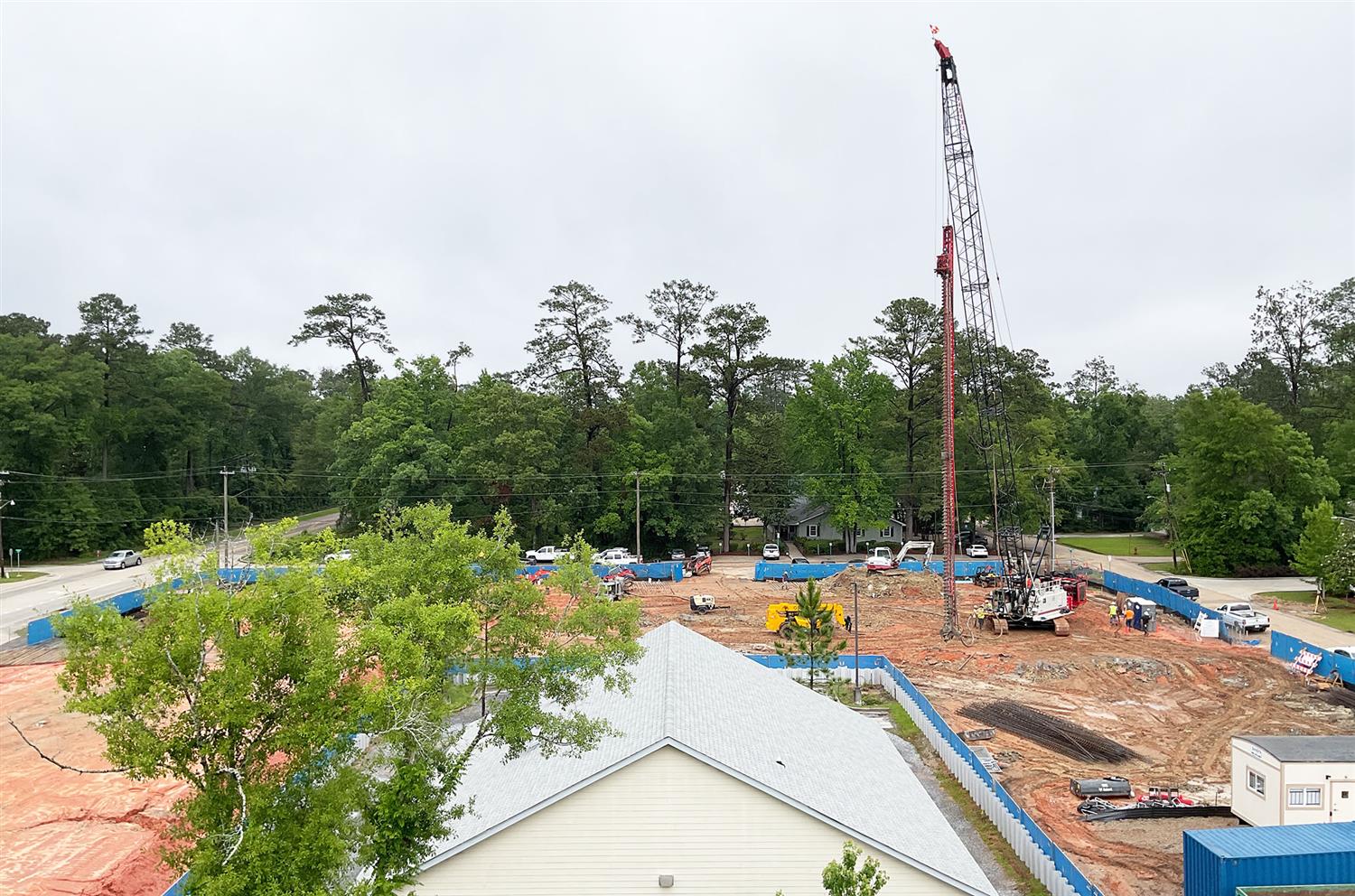

PHOTO OF THE DAY: A crane outfitted with an auger -- which is the long, spiraled shaft at the center of the photo -- is put into position as crews prepare to transition this week from drilling test piles to production piles across the site of the future STHS parking garage. The auger-cast piles to be used in the project are noteworthy because they require no pounding. The above photo was taken on Monday, April 20, 2026. (STHS photo)(STHS photo)
April 17, 2026

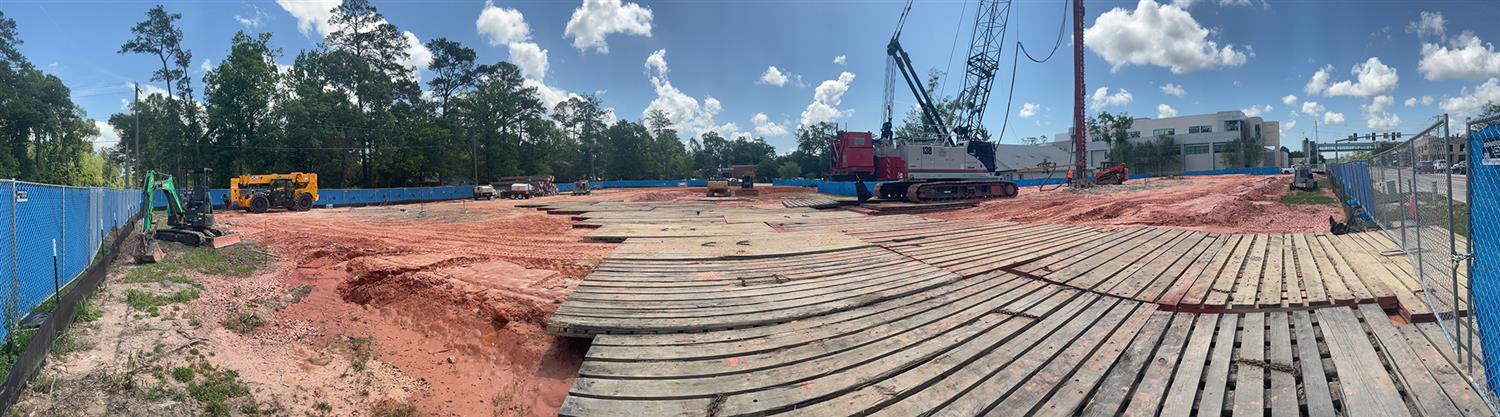

PHOTO OF THE DAY: Crews use a crane to bore test piling holes on the site of the future St. Tammany Health System parking garage on Friday, April 17, 2026. Barring any unforeseen delays, they will proceed to placing production piles in coming days and continue for several weeks. (STHS photo)
With site preparation continuing on the STHS parking garage project along South Tyler Street between West 11th and West 12th avenues, here’s what colleagues and neighbors can expect as work progresses:
April 13, 2026

This view from the STHS pedestrian Skybridge over South Tyler Street, taken April 8, 2026, shows the crane being used to install auger-cast piles on the site of the future STHS parking garage. Construction fencing on the hospital side of West 11th Avenue, near the photo’s center, shows where work will take place to prepare the hospital building for its end of a pedestrian skybridge that will lead from the garage. Additionally, the pine trees at the right of the photo will be removed as part of the garage project and a separate utility rack project. Those trees will be replaced in strict adherence to municipal beautification standards. (STHS photos)

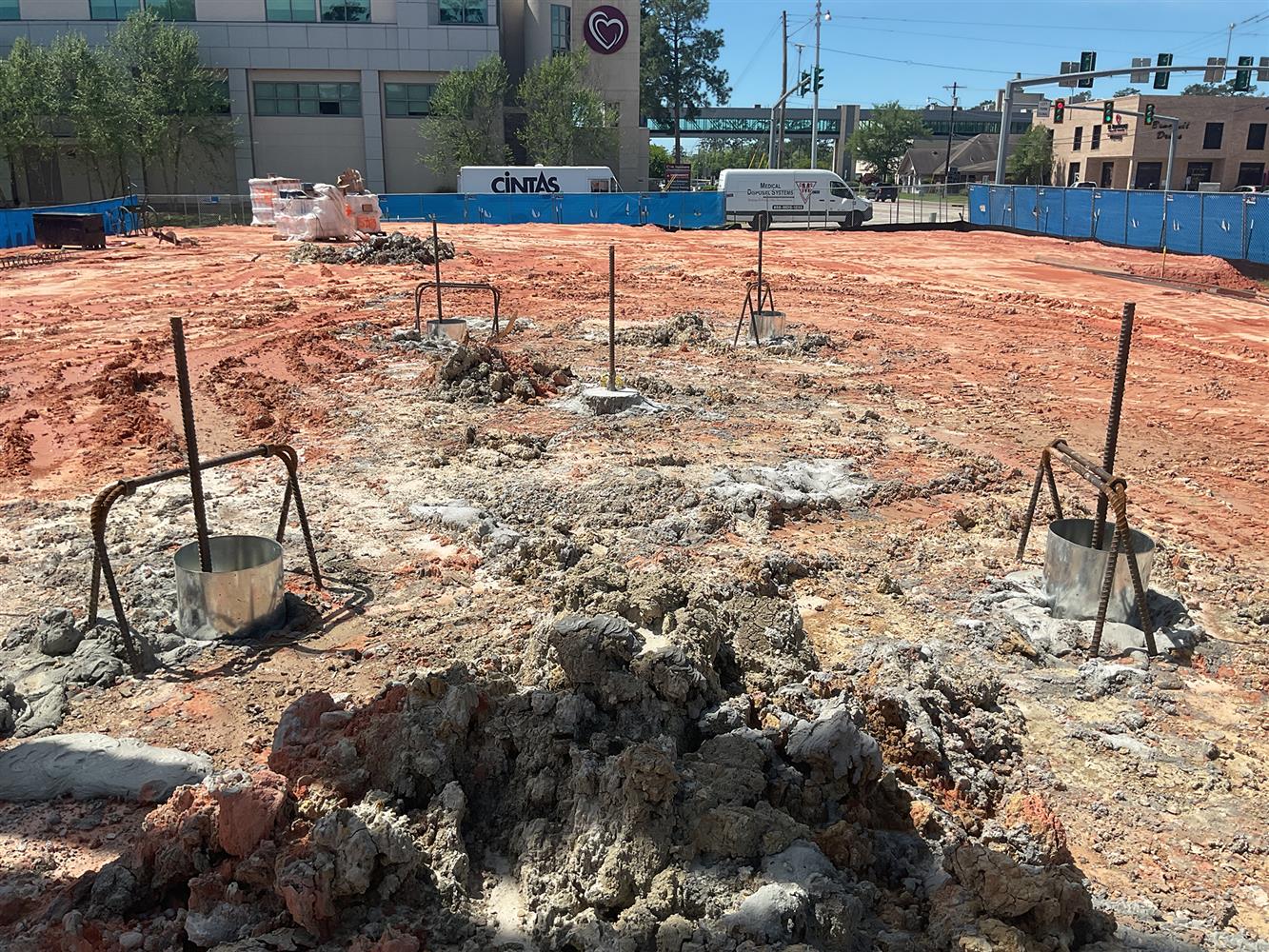

This photo, taken April 7, 2026, shows a close-up look at the auger-cast test piles recently installed on the site of the STHS parking garage. The installation of auger-cast piles – which require no pounding – will transition in coming days and weeks from the test phase to the production phase, with installation of a network of production piles across the garage site.
With initial dirt work complete, site preparation continues apace on the STHS parking garage project at the corner of West 11th Avenue and South Tyler Street. Here’s what colleagues and neighbors can expect as the project progresses:
April 6, 2026

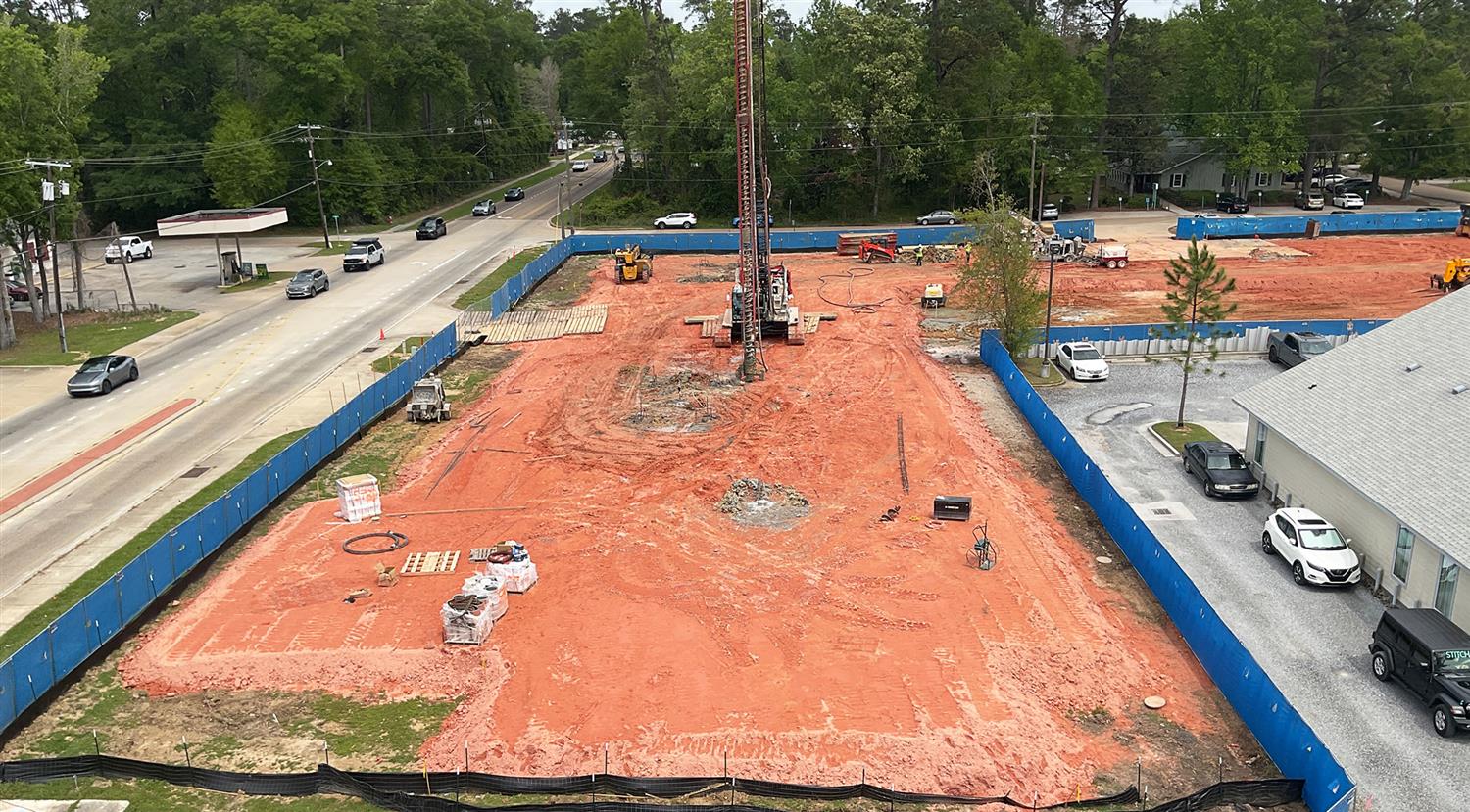

PHOTO OF THE DAY: A crane rises above the site of the future STHS parking garage on Thursday, April 2, 2026. The crane is being used to drill auger-cast test piles before construction begins in earnest. (STHS photo)
With site preparation in full swing on the STHS parking garage project at the corner of West 11th Avenue and South Tyler Street, here’s what neighbors can expect in coming days and weeks:
March 26, 2026

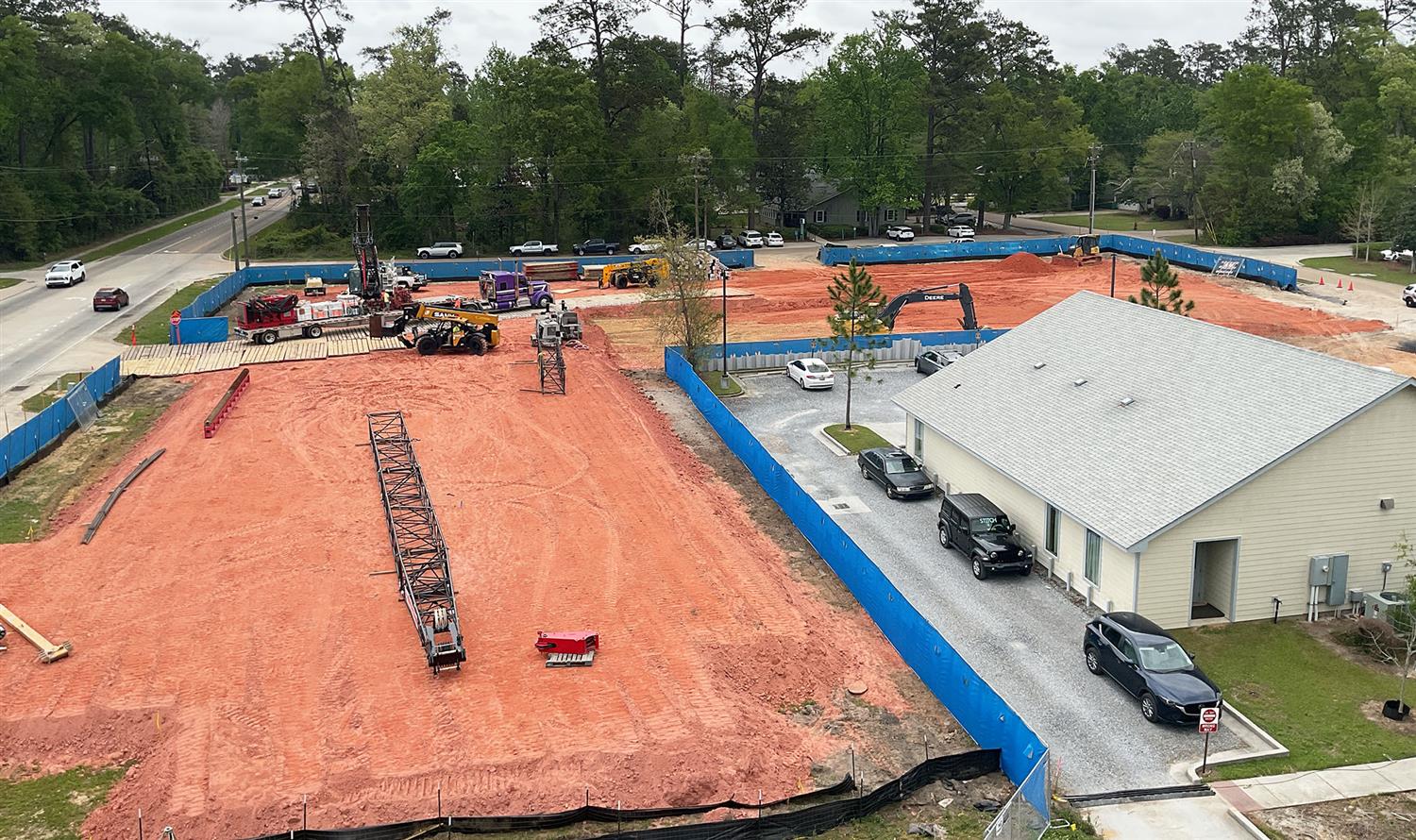

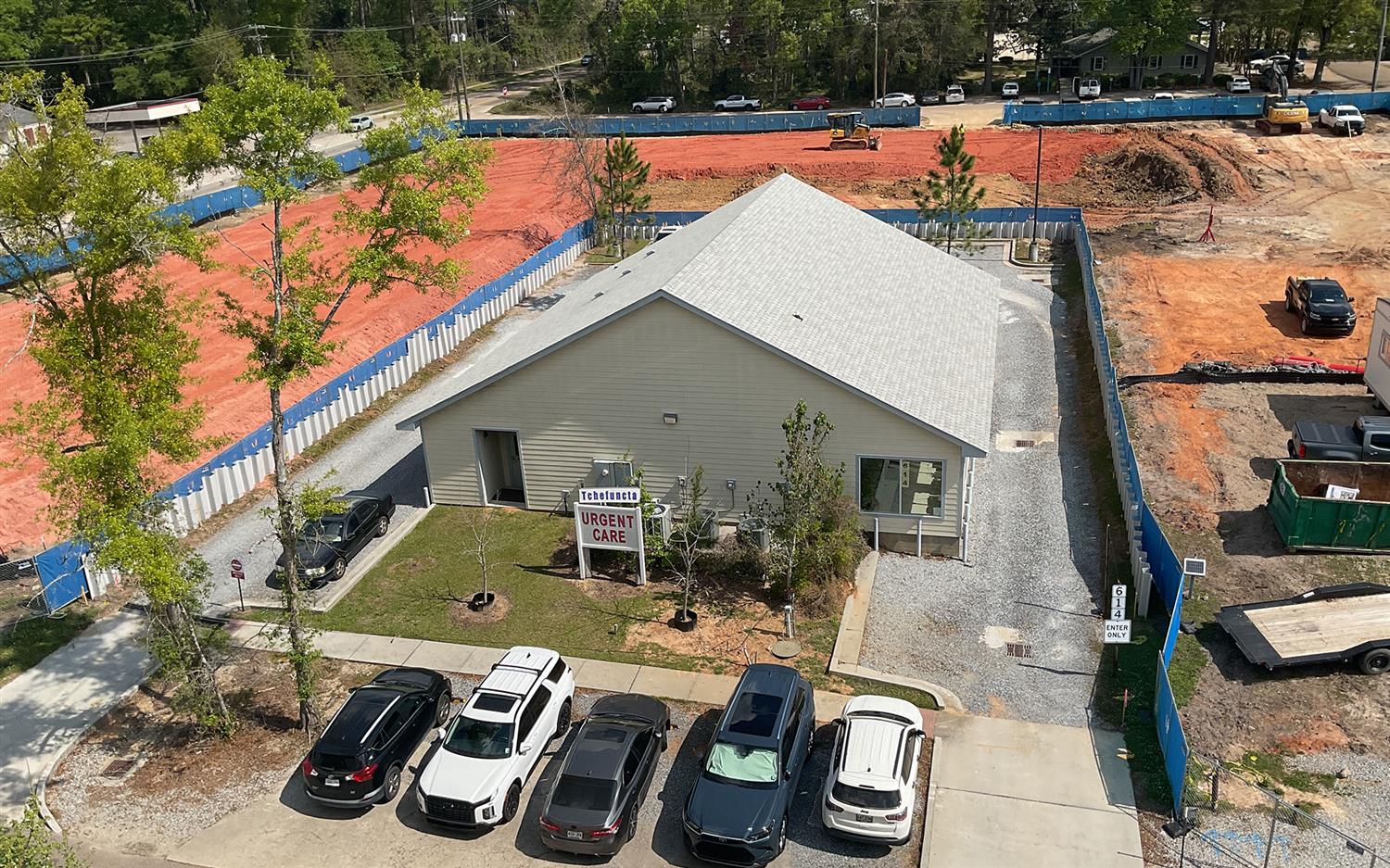

A bird’s-eye view of the site of the future St. Tammany Health System parking garage, as seen Thursday, March 26, 2026. Sheet piles have been installed around the privately owned Tchefuncte Urgent Care building, and construction fencing rings the perimeter of the garage site while dirt work continues. (STHS photo)
Site preparation continues on the STHS parking garage project at the corner of West 11th Avenue and South Tyler Street, with dirt work (grading) continuing ahead of the commencement of construction. Here’s what colleagues and neighbors can expect in coming days and weeks:

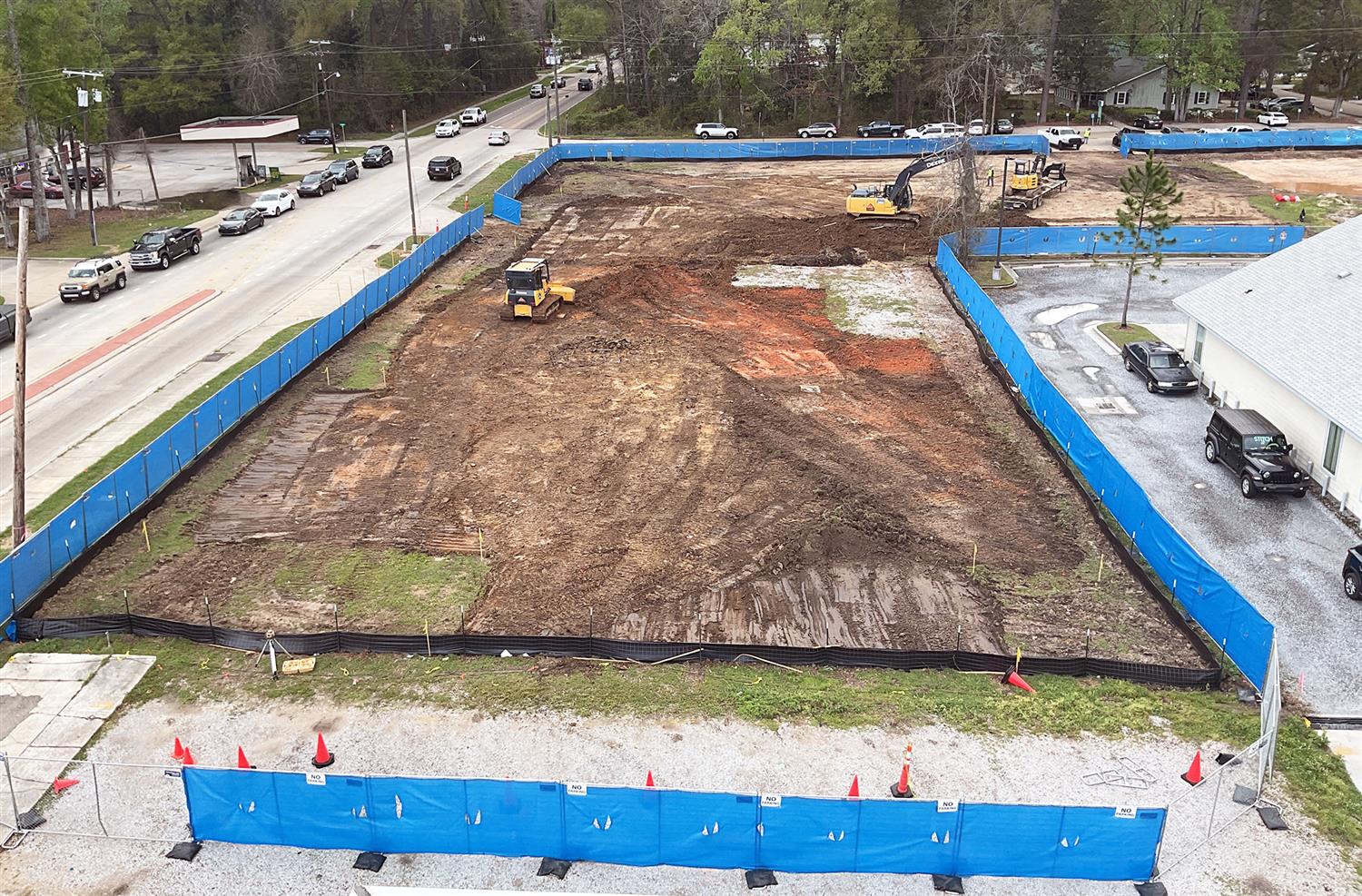

An aerial view of the future home of the STHS parking garage, taken on March 16, 2026. (STHS photo)

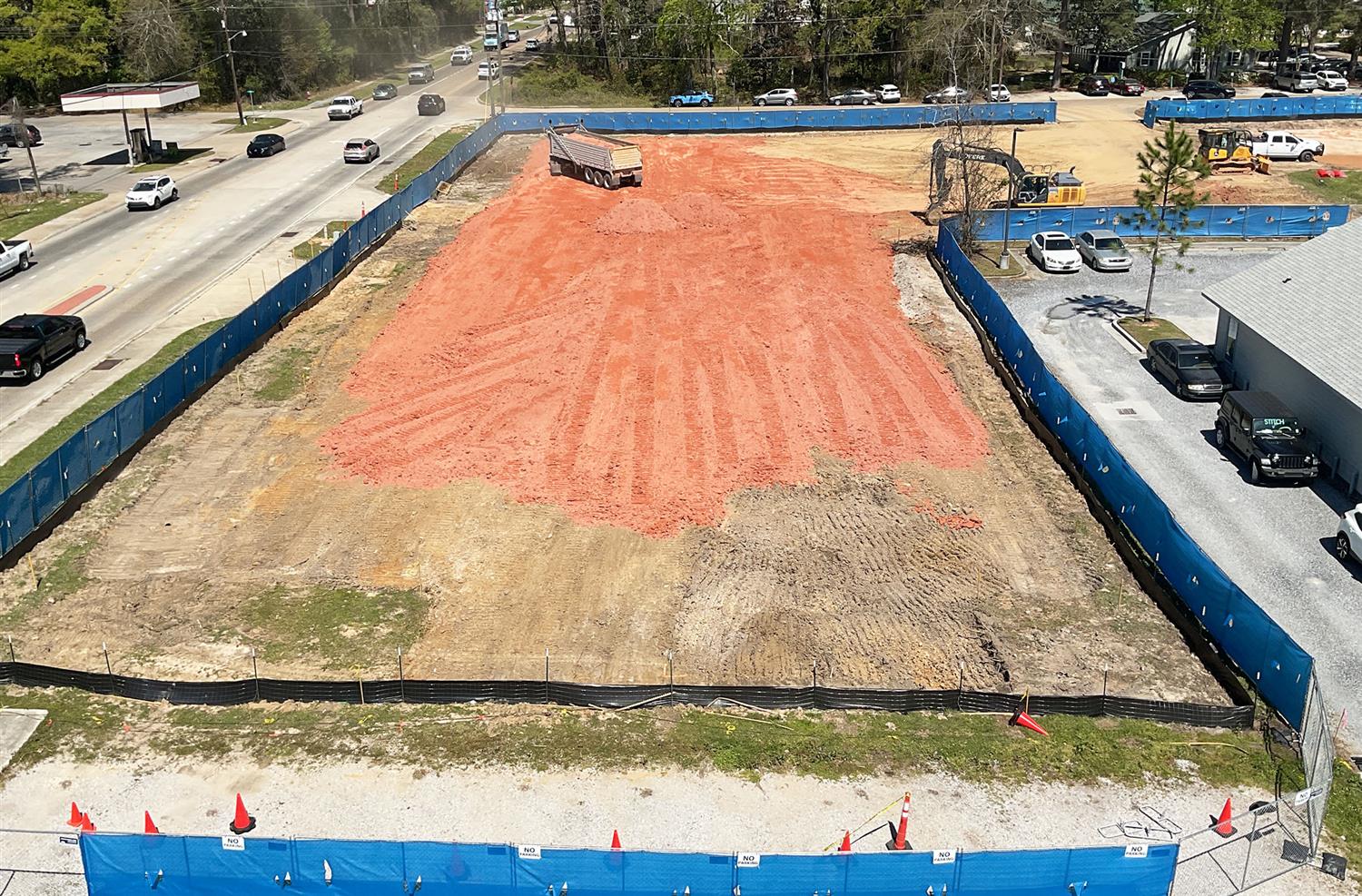

The same section of the work site, as photographed on March 19. (STHS photo)
March 12, 2026

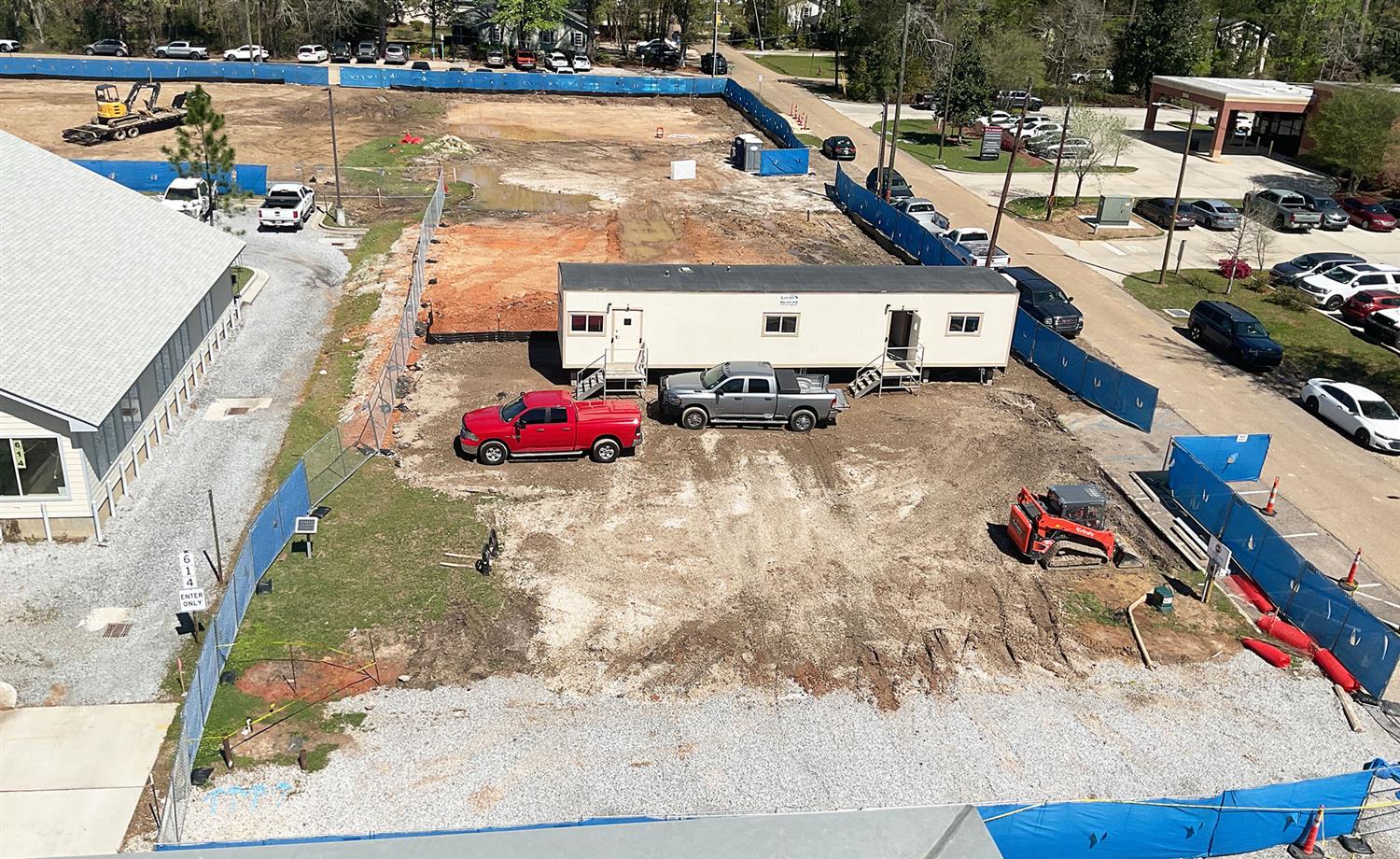

PHOTO OF THE DAY: As part of their site preparation work, crews added a construction trailer to the site of the future STHS parking garage on Thursday, March 12, 2026. (STHS photo). (STHS photo)
Site preparation continues on the STHS parking garage project, with construction fencing and blue windscreen now completely ringing the site. In coming weeks, colleagues can expect to see:
March 5, 2026

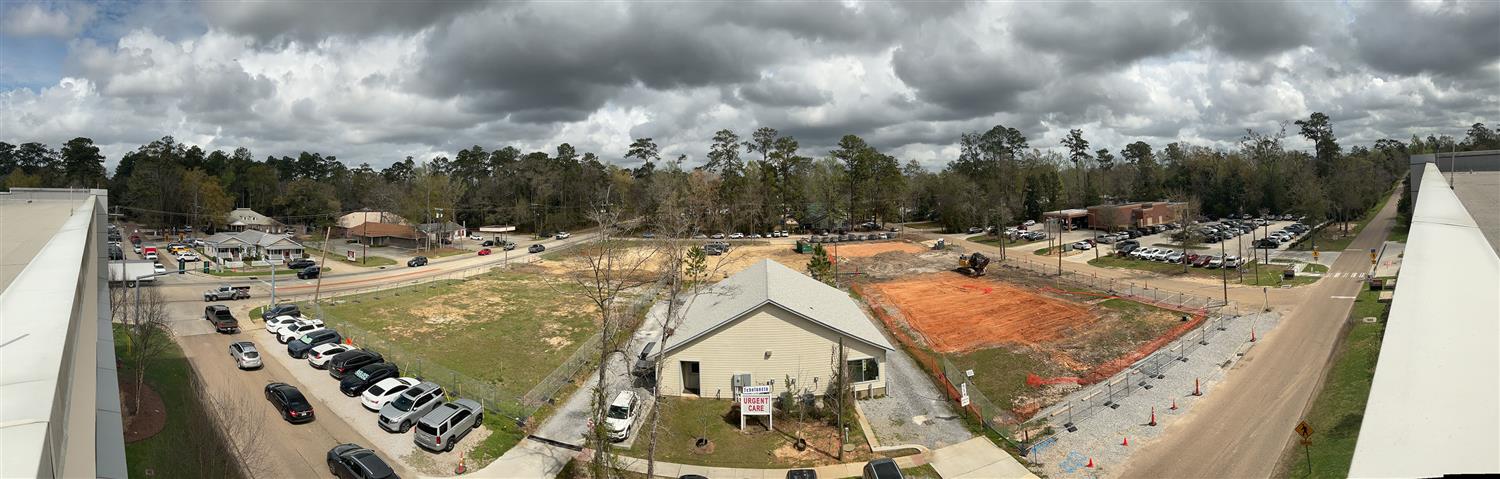

PHOTO OF THE DAY: An aerial view of the site of the future STHS parking garage, as seen from St. Tammany Parish Hospital on Thursday, March 5, 2026. (STHS photo)
Site preparation continues on the STHS parking garage project. In coming weeks, you can expect to see:
Feb. 7, 2026: Crews begin site mobilization. This will include:
Jan. 12, 2026: To accommodate garage construction, St. Tammany Health System's Northlake Surgical Associates practice has relocated to 728 W. 11th Ave, just one block from its previous home on the site of what will become the garage.
May 2024: After years of planning and study, St. Tammany Health System announces to its colleagues that it is taking the first steps toward building a new parking garage to serve its flagship St. Tammany Parish Hospital in Covington. The five-level parking structure, to be located across W. 11th Ave. from the hospital's Emergency Department, is designed to serve the hospital's growing parking needs and provide a rooftop helistop closer to its Emergency Room, giving our team precious additional minutes in a critical care situation.

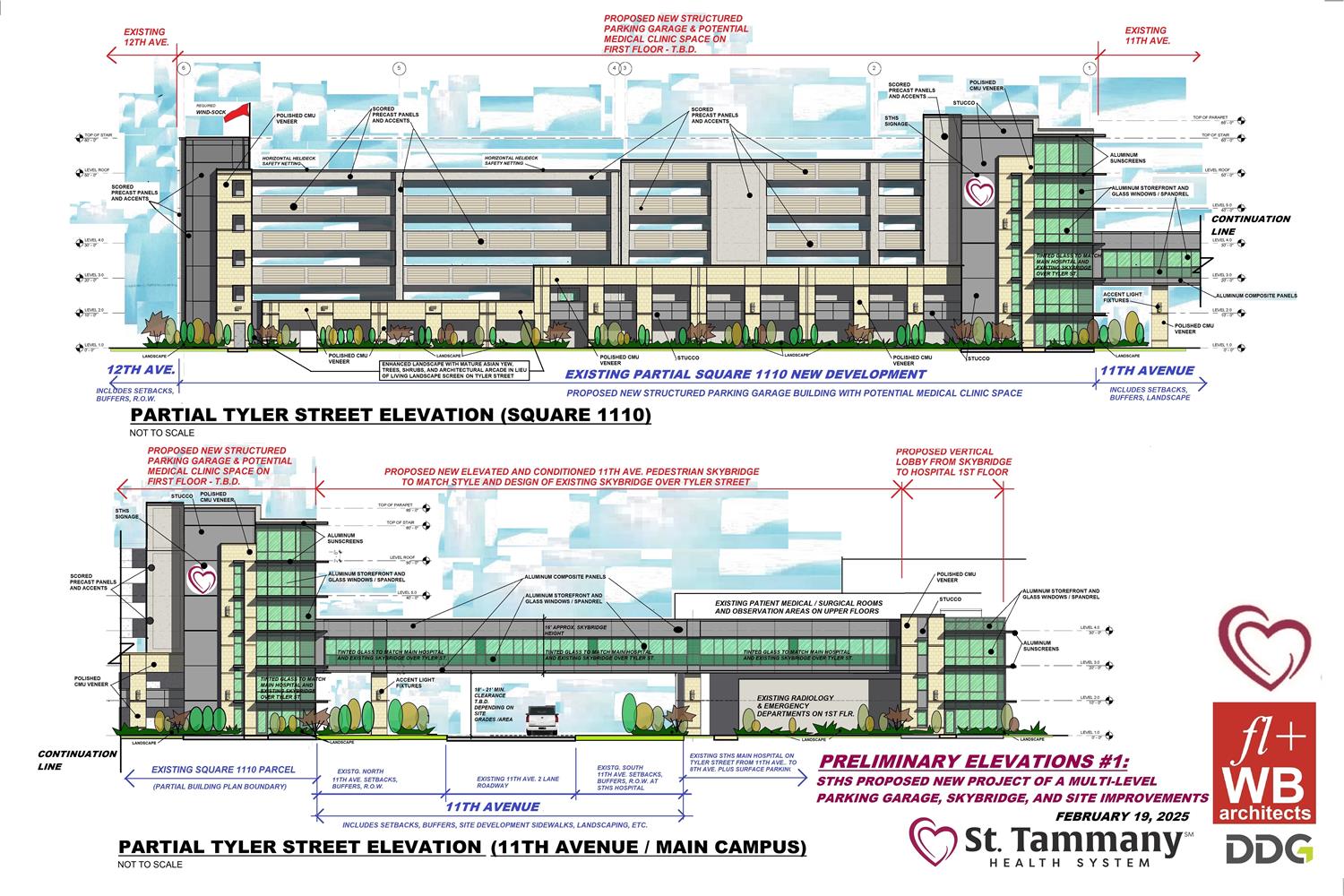

Below is an artist's rendering of the new structure, which was designed to harmonize aesthetically with the existing hospital building and the pedestrian Skybridge over S. Tyler Street.
